How to expertly use time management tips and different scheduling methods for your project, including Node diagrams and Gantt charts.
Now that we know what work needs to be completed, we need to determine when we can do the work. Projects are time-bound; therefore, a project needs to be completed on schedule or as close to on schedule as possible – some delays may be inevitable. The stress often related to completing a project can be managed by having better control over our time.
A project schedule requires that we know (or can estimate) multiple aspects of each task. This includes how long each work task will take, the dependency of one work task on another, and the amount of effort required for each task. This includes questions such as: which task must occur first?; which tasks can I complete quickly?; which tasks will take the longest?
Remember that if the project is new, or even just new to you, accurately estimating the project (or the individual tasks) time requirements may be difficult. Asking colleagues, friends, etc. maybe be very helpful, especially those who have done the same or similar task before.





Source: Image by upklyak
Other people’s schedules can complicate project scheduling and timelines considerably. For example, if you rely on a meeting with your supervisor to move forward on your project you may have to wait several days for this meeting so that you can fit into your supervisor’s schedule, even if your own schedule is completely open. In addition, consider the passive time that occurs in between periods of active work. For example, sending an email may only take 10 minutes but we may need to wait for a response before we can proceed to the next task. In that situation, we need to incorporate the amount of time into our project schedule that someone will reasonably need to respond to our email. The difference between passive and active time is the key difference between effort and duration.
Instructions: click on the two tabs below to learn more about each of these two terms.
The amount of work or the time it takes to complete a task. For example, if it takes 6 hours a day for 3 days to complete the data collection for a specific experiment the effort required is 6 x 3 = 18 hours.
The entire time taken to complete a task, including time where work is not actively being completed (i.e., passive time). Duration stretches from the moment the task or project begins to the moment that it ends. Considering the previous experiment example, while the effort is only 18 hours, the duration for this task would be 3 days or 72 hours.
There are several techniques for managing project schedules. In this section of the module, we are going to look at two: Node/Network diagrams and Gantt charts.
Before we learn about some methods for scheduling, take the time to reflect on your current time management skills. Make a post in Discord to answer the following two questions:
You can upload images, examples, or resources you have used, too.
In this portion of the module, we will show you two scheduling techniques specifically used for creating project schedules. Both are effective tools for project scheduling, but which one you decide to use ultimately depends on your personal preferences.

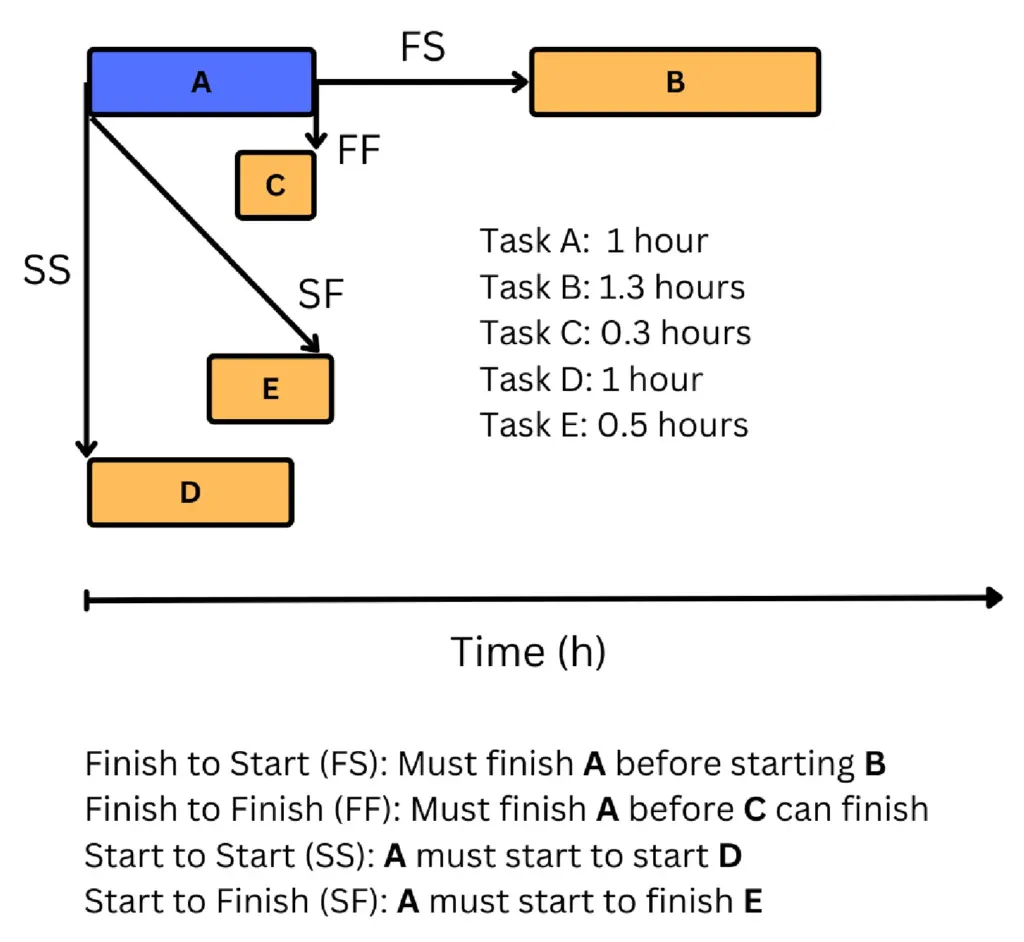

Node and network diagrams are a simple “connect-the-box” style diagram that shows the dependencies of work tasks on each other. The boxes typically name the activity and show duration (either a rough estimate of duration or more exact start and finish times) based on the length of the box. The arrows in the diagram show dependencies between tasks.
Instructions: Click the Play button for an audio description of the image.

Dependencies are important to identify during scheduling for several reasons:
The critical path: The activities that define the shortest time the project can possibly be completed in.
Now let’s use a practical example and try to make a Node and network diagram. Below is a list of activities and their estimated duration (in hours) needed to complete each activity. Draw a node and network diagram with this information in your Workbook.

Go to your Workbook and write your answers.
NOTE: For activity G in the below table, although it won’t take you 48 hours to send the email, we are accounting for the estimated response time; therefore, we are considering duration for this activity not effort. You may be able to work on other projects/tasks in situations like this where the duration is long, but effort is short.
| Activity | Duration (hours) |
|---|---|
| A: Literature research on topic(s) | 10 |
| B: Create research question | 0.5 |
| C: Research design | 2 |
| D: Brainstorm narrative and outline grant proposal | 1 |
| E: Write a draft | 5 |
| F: Proofread and edit draft | 2 |
| G: Send draft for proofreading/feedback from peers and/or supervisor | 48 |
| H: Finalize draft | 2 |
| I: Submit draft | 1 |

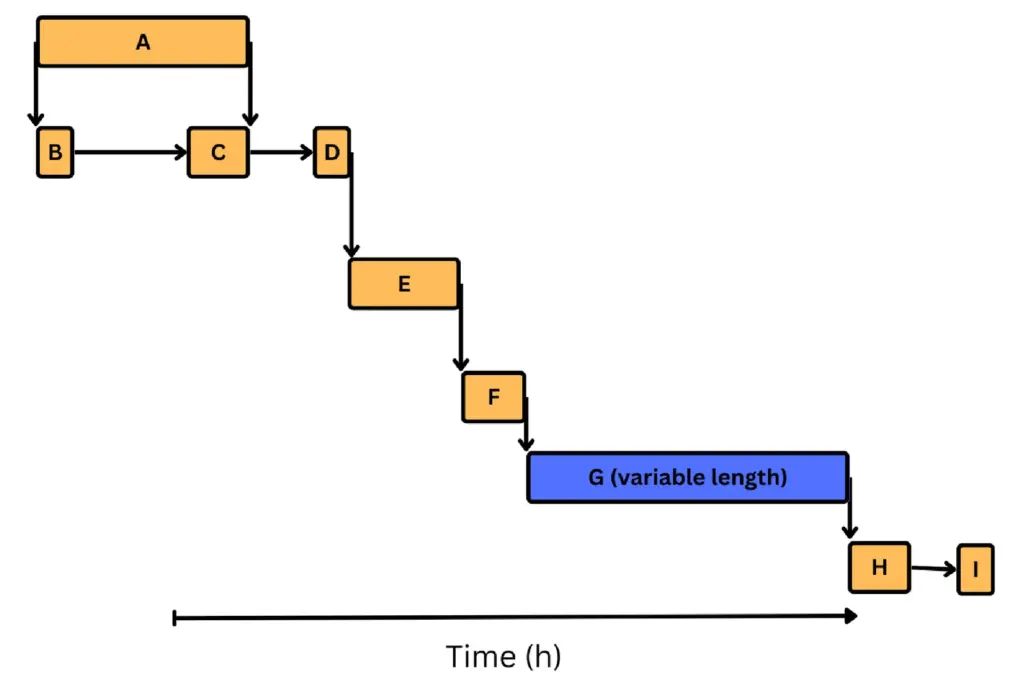

The graphic shows a completed node diagram using the given example; yours may be slightly different. In our example, notice that we have activity B and C completed during activity A, and that we cannot progress to activity D until all three prior activities are completed. Logically, we have also placed activities D through I in a finish-to-start sequence as each task should be individually completed prior to moving on to the next activity.

A line graph with “project progress” increasing along the x axis and “your effort” increasing along the y axis. The graph area is broken into three sections and divided by three vertical blue dotted lines. The first section is 1/4 of the entire graph width and represents the “initiation and planning” phase. The second section is to the right of the first and is 1/2 of the entire graph width representing the “execution of tasks and objectives” phase. The final section is to the right of the second and is the final 1/4 of the graph width representing the “project closure” phase.
The line that is drawn on the graph starts near the graph origin and increases on a 45 degree angle to near the top of the graph height slightly after the start of the second phase (execution of tasks and objectives). The line remains near the top of the graph until near the end of the second phase and then decreases on a 45 degree angle through the project closure phase until the line is near the end of the x axis and near the bottom of the y axis.
The graph represents the increasing effort as you move from initiation and planning into the execution phase, then the decreasing effort as you move from execution to project closure.
Gantt charts are another way to graphically represent a project timeline. In this type of diagram, deliverable progress is shown as a horizontal bar that gets filled in as the task is completed. Dependencies are shown with arrows, similar to the node and network diagram.

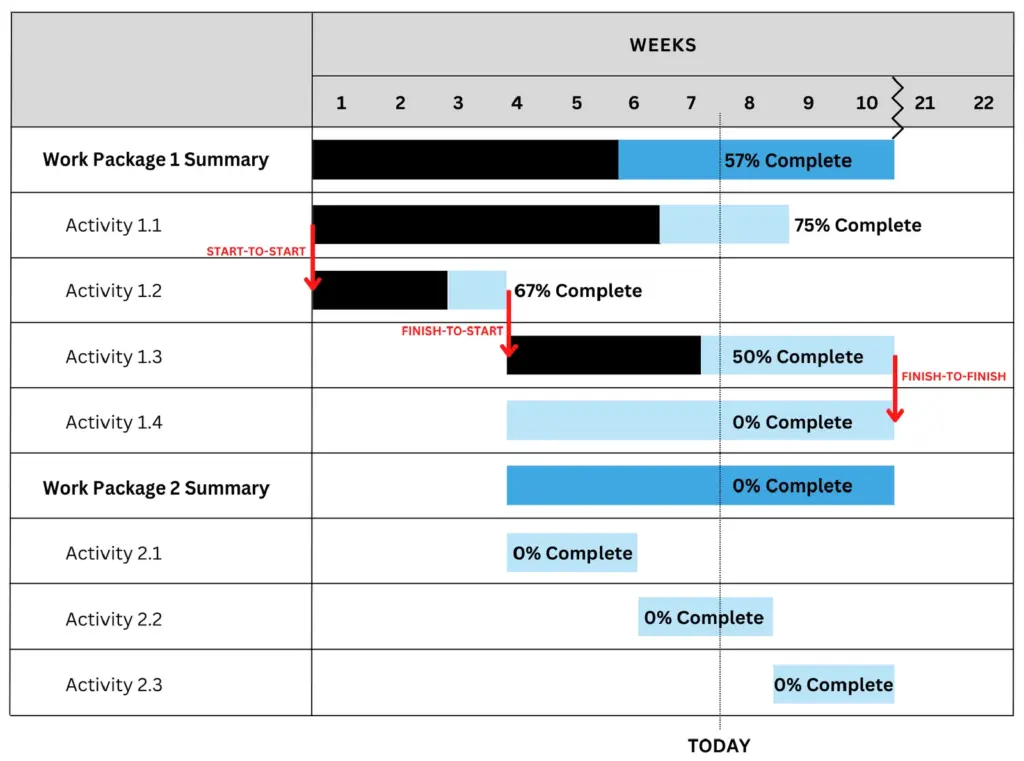

A Gantt chart is a bar chart illustrating a project schedule. Each bar represents an activity and dependencies are indicated by arrows or by the alignment of bars. In the example, activities 1.1 and 1.2 are aligned start-to-start, such that both activities can begin at the same time because they are not dependent on one another. To contrast, activity 1.2 and 1.3 are aligned finish-to-start, such that activity 1.3 cannot begin until 1.2 is completed.
Instructions: Click the Play button for an audio description of the image.

Gantt charts can be more difficult to create, but there are extensive Microsoft Excel templates (like this one) as well as online resources (including Monday.com) that can help organize these charts without too much initial hands-on effort.
In addition to the techniques for managing project schedules, personal AND project calendars can help keep tasks on track from a broader perspective.

A personal calendar keeps YOU on track and is useful for keeping track of classes, appointments, exams, etc.

A project calendar tracks tasks, milestones, and due dates and can be shared with all team members so that the entire PROJECT stays on track.
Digital as well as analogue (paper and pen) calendars each have their own benefits. Choose what works best for you and what you will actually use. We encourage you to try out various ways, even if they feel uncomfortable at first, so that you can make a more fully informed decision.
The best calendars are as thorough as possible. They include “hard” scheduled activities like classes, appointments, and meetings, as well as other activities like going to the gym, or a lunch break. If it is in your calendar, you are more likely to commit to doing it!
A lot of people find it useful to “block out” time in their calendar to work on ongoing projects. For example, you might find that you’re very productive at writing between 2 and 3 pm so you schedule “Write Thesis” into your calendar in that timeframe every day. Although you won’t finish writing your entire thesis in that time and your thesis may not be due for months, setting aside time to progress on the project little by little will help in the long run.
In the project “close-out” that we will discuss in a coming section, you will also reflect on whether your time estimates were accurate. That reflection will help you more precisely estimate time for future projects with similar tasks! For example, if you estimated that it would take 15 minutes to edit your resume, but it actually took 2 hours, you will be able to readjust your estimates in your calendar the next time you have to make resume revisions.
Techniques such as making a Gantt chart, Node and network diagrams, and using a calendar are useful for different reasons. Calendars help you organize your time and schedule work periods while the other techniques are the project timeline and the schedule.
These techniques complement each other to ensure you can stay on top of your project and associated deadlines!
However, each person is unique and some may prefer other organization methods. We’ve listed some other organization methods below:
Lists tasks that need to be completed, ordered or not. These lists can be made daily, weekly, or per project. If you do choose to create a to-do list for a longer period of time, it would be better to order them either by importance or due dates.
Lists of tasks that are sorted by priority. Tasks may be grouped together even if they may differ in priority if it’s easier to do them at the same time (e.g., You may need to go to campus to hand-in assignments you’ve graded – high priority – and since you’re already there, it would also be easy to return your friend’s lab coat – low priority – thus, these tasks are grouped together].
A creative way to map out your tasks and calendar. There’s a variety of ways to do this and this is very customizable. Some people have also created templates online, just search “bullet journal” on the internet!
A diary for your appointments. May also include a calendar and to-do lists.
Mix and match the organizational methods you prefer!
We’ve discussed multiple techniques and methods to schedule your time. Now let’s practice! Using your goal and project from the “setting SMART goals for a project” activity, create a schedule using the method of your choice that includes a weekly timeline as well as important deadlines/target deadlines. Consider using a method that you haven’t used before or that you find less comfortable—this is a great opportunity to enhance your skills.
Consider:
For this activity there is no requirement to share the information; you can complete this activity in your Workbook. Feel free to share ideas and ask questions in discord.

Go to your Workbook and write your answers.
Although we’ve described how to schedule your time and plan your project timelines there’s still one critical challenge everyone encounters – lack of productivity.
We all hope to be productive, but the reality is that the task at hand takes time and deep thinking, or takes more time that you expected. For example, you may need to read dozens of research articles before being able to write a single paragraph in an introduction. That time and depth are needed to understand the area enough to write about it (and that’s okay and normal).
something we can control and other times it’s not a lack at all and instead is part of doing advanced and challenging work.
Source: Image by wayhomestudio
For the aspects we can control, there are techniques to combat procrastination and distractions.
A method for staying focused and mentally fresh. You’re meant to engage in a “Pomodoro” (steps 1 to 4) uninterrupted. The designated breaks are important so that you can focus more during your designated working time. The steps are outlined below. The pomodoro technique is so popular that many people have designed pomodoro apps and websites!
A method for staying focused and mentally fresh. You’re meant to engage in a “Pomodoro” (steps 1 to 4) uninterrupted. The designated breaks are important so that you can focus more during your designated working time. The steps are outlined below. The pomodoro technique is so popular that many people have designed pomodoro apps and websites!

Outline 5 things you can commit to doing before 11 am the next day, every day. By completing these tasks before 11 am the next day, you can start your next day with a sense of accomplishment and be more encouraged to conquer the new day!
These are just a few popularized techniques people have used to combat procrastination and distractions from work. Feel free to try them out and figure out what works best for you!
Unfortunately, as much as we try to plan and schedule things there are limits to what we can control. We should acknowledge these limitations in ourselves and our team members.
For example, neurodiversity means that different people approach projects in a variety of different ways. In addition, everyone’s personal lives and experiences may limit working hours or their ability to focus when they are physically present at work.


We need to acknowledge and account for these variations and needs in our project plan and schedule. We should also remember to always respect everyone’s boundaries and to set our own. For example, you may prefer to work on weekends but others may have that time set as outside of business hours reserved for personal time.
In general, account for these factors in your schedule. Often, communicating about what is needed and coordinating deadlines and meetings around any limitations can be the simplest solution. Some other general tips include providing information and questions prior to any meetings so that people have time to process and consider the information, providing clear and concise instructions and actions so that everyone can confirm their understanding, avoiding the use of jargon or metaphors to improve clarity, and allowing for breaks and frequent question periods.
